Transmission services for AKELCOโs Caticlan and Boracay Substations have returned to their regular configuration following the successful connection and energization of the new Caticlan 69kV XLPE Underground Cable and the completed rehabilitation and reconducturing of the entire Unidos-Caticlan 69kV Line. The temporary bypass line installed to maintain services during rehabilitation has now been safely disconnected.

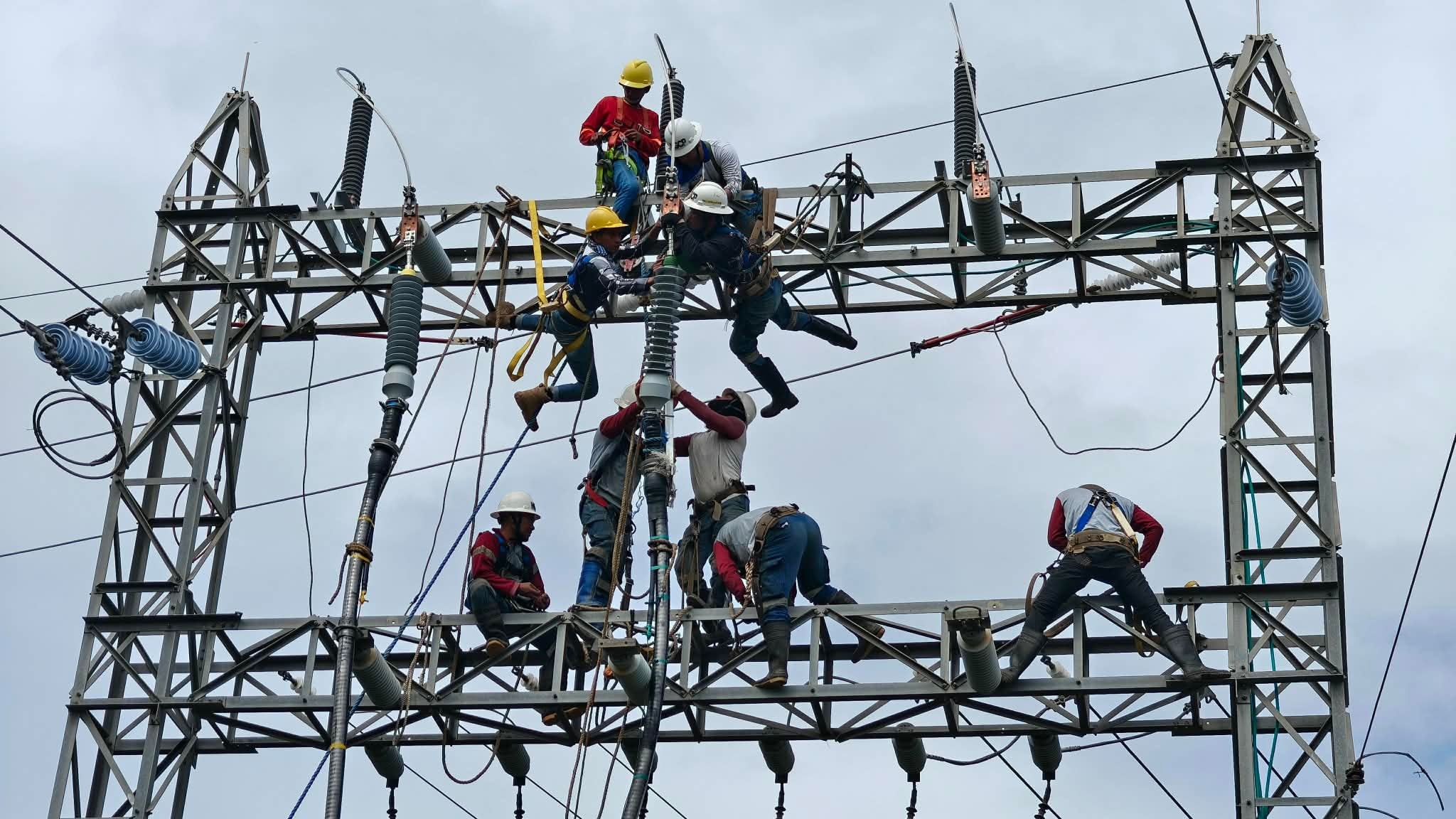

NGCP deployed 24 line gangs from other parts of the Visayas and South Luzon to fast-track the project. The work was particularly challenging, as the Unidos–Caticlan line runs through mountainous terrain, with structures spanning ridge to ridge. Unfavorable weather conditions brought about by Tropical Storm Basyang and limited working hours in compliance with safety regulations posed by the Civil Aviation Authority of the Philippines (CAAP) further added to the difficulty. Despite these constraints, the project was completed safely and efficiently, ahead of the scheduled ASEAN Summit activities this March and the summer peak season in Boracay.
โWe are proud to have restored the Unidos-Caticlan 69kV Line ahead of schedule despite various challenges and limitations. This is testament to the dedication of NGCP to ensure the reliability of transmission services in Aklan, particularly in the areas of Caticlan and Boracay, a vital tourist hub for the countryโ, NGCP said.
Prior to NGCPโs assumption of operations, the Unidos-Caticlan 69kV Line was under the operation and maintenance of Aklan Electric Cooperative (AKELCO). In September 2025, the 69kV cable sustained significant damage. AKELCO subsequently acknowledged its inability to finance the required repairs, which prompted the Energy Regulatory Commission (ERC) to issue a resolution in October 2025 transferring the responsibility for the operation and maintenance of the line to NGCP. Upon formal turnover, NGCP immediately conducted a comprehensive assessment of the facility and found that approximately 88% of the identified defects were corrosion-related, largely due to prolonged exposure to harsh marine conditions. NGCP promptly initiated corrective measures and implemented a rehabilitation program to address structural weaknesses and restore the integrity of the line.
As part of its action plan, NGCP committed to rehabilitating and strengthening the line, with full reconductoring originally targeted for completion by March 2026. Through intensified coordination, additional manpower, and round-the-clock work, NGCP was able to complete the necessary upgrades and energize the line nearly a month ahead of schedule.
The restoration works were initially projected to require six shutdowns. Through careful planning, these were reduced to four scheduled outages conducted on January 27, February 3, February 12, and February 13, helping minimize inconvenience to affected consumers.
